Gantt Chart: What It Is and How to Build One (With Examples)

What Is a Gantt Chart? illustrated by a wide elegant schedule with horizontal task bars, dependency arcs, and one milestone diamond

Turn this article into takeaways for your work.

Each assistant summarizes the article only for you and suggests best practices for your work.

A Gantt chart is one of the most widely used tools in project management, giving teams a visual snapshot of every task, deadline, and dependency on a single timeline. If your projects regularly slip, miss handoffs, or leave team members confused about what comes next, a well-built Gantt chart is often the fastest fix.

What is a Gantt chart?

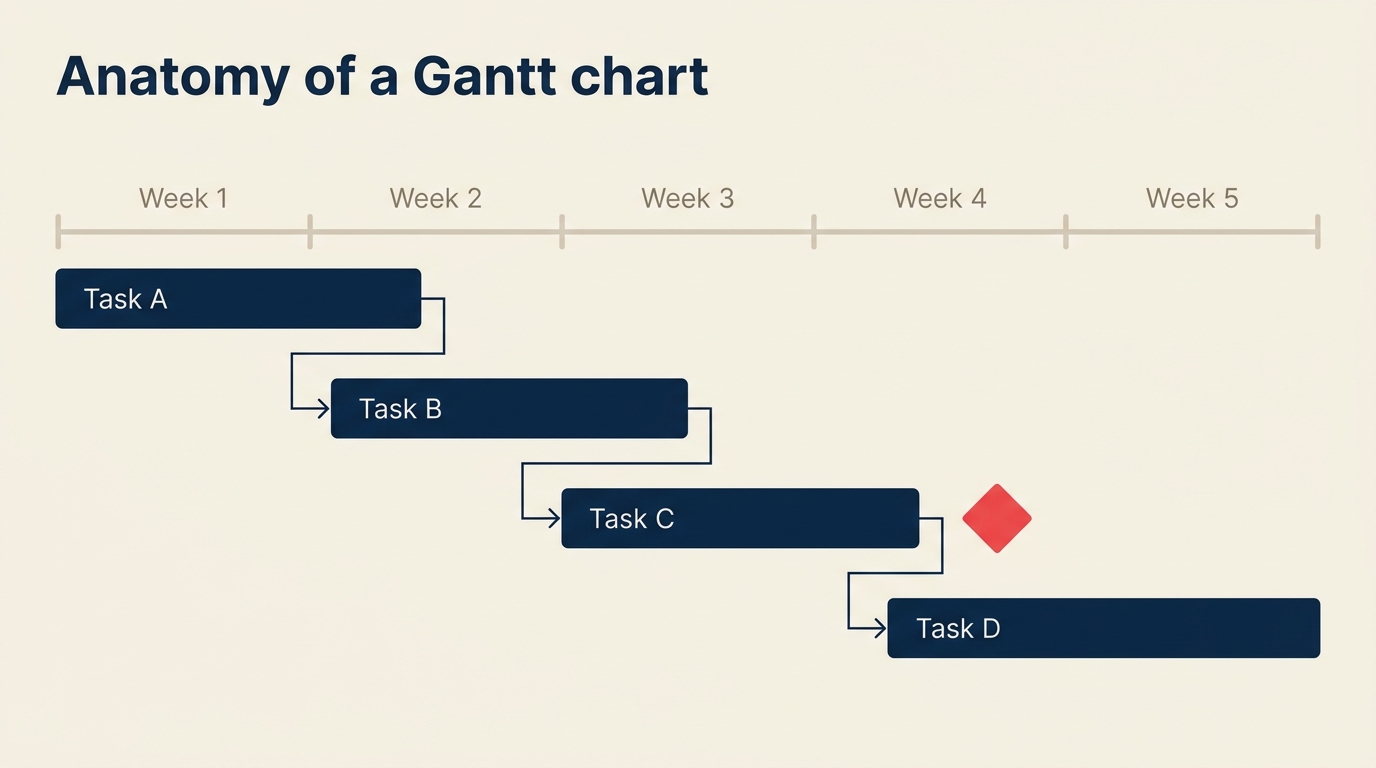

A Gantt chart is a horizontal bar chart that maps project tasks against a time axis, showing when each task starts, how long it runs, and how tasks relate to one another through dependencies. Each bar represents one task; the bar's length equals the task's duration; and arrows or link lines between bars show which tasks must finish before others can begin.

The tool is named after Henry Gantt, an American mechanical engineer who popularized the format in the 1910s for factory scheduling. Less often cited is Karol Adamiecki, a Polish engineer who independently developed a nearly identical "harmonogram" in 1896. Gantt's broader publication in English-speaking markets gave the chart its lasting name.

Today, Gantt charts appear in construction, software development, marketing, healthcare, and virtually every industry that runs multi-step projects. They work at any scale, from a three-person team planning a website launch to a program office coordinating hundreds of workstreams.

Key Facts

Key Facts: Gantt Charts and Project Visualization

  • PMI's 2023 Pulse of the Profession found that organizations using formal project visualization tools complete significantly more projects on time and within budget compared to those that don't. (PMI, Pulse of the Profession 2023)
  • Gartner estimates the global project management software market will surpass $9.8B by 2027, driven largely by demand for visual planning features. (Gartner, 2024)
  • A 2024 Wellingtone State of Project Management report found that 55% of organizations still rely on spreadsheets to manage projects, despite widespread availability of dedicated tools. (Wellingtone, 2024)

Gantt chart vs Kanban vs PERT vs network diagram

Tool Best for Time axis Shows dependencies Effort to build
Gantt chart Scheduled, deadline-driven projects Yes (calendar dates) Yes (link lines) Medium
Kanban board Continuous flow, support queues No No Low
PERT chart Early estimation under uncertainty No (sequence only) Yes (arrows) High
Network diagram (CPM) Finding the critical path in complex builds No Yes High

When a Gantt chart wins. Choose a Gantt chart when you have a defined start date, a fixed deadline, and tasks that must happen in a particular order. A software product launch, a construction fit-out, and a marketing campaign all fit this pattern. The time axis keeps the team anchored to the calendar rather than just a workflow sequence.

Gantt vs Kanban vs PERT illustrated by four wide but sparse planning artifacts with distinct silhouettes: timeline, columns, branching nodes, and dependency network

When Kanban wins instead. If work arrives unpredictably or the backlog never truly ends, a Kanban board beats a Gantt chart because it focuses on throughput, not schedules. Help desks and customer success teams typically get more from Kanban than from Gantt charts.

When PERT or CPM wins instead. For research-heavy projects where you genuinely don't know how long tasks will take, PERT's three-point estimation (optimistic, most likely, pessimistic) gives more honest timelines. Network diagrams pair well with PERT when you need to surface the critical path before committing to a schedule.

Benefits of using a Gantt chart

  • Shared visibility across the team. Everyone from the sponsor to the junior analyst can see the same timeline at a glance. There's no need to read a 40-page project plan to understand what's happening this week.
  • Dependency management. Link lines make it obvious that the design sprint can't start until discovery wraps. This prevents the common situation where a downstream team is waiting while the upstream team doesn't even know they're blocking anyone.
  • Early warning on slippage. When a task bar moves right, every downstream bar shifts with it. A Gantt chart makes the knock-on effect of delays visible immediately, not after the missed deadline.
  • Milestone tracking. Critical delivery points, such as a client sign-off or a regulatory filing, show up as distinct markers on the timeline. Stakeholders can see in seconds whether the project is on track for what matters most.
  • Resource load visibility. Most modern Gantt tools let you assign owners to each bar. Looking down a column of names tells you instantly whether one person is scheduled for six parallel tasks while another has nothing.
  • Baseline comparison. Once you lock the original plan, any future changes show as a variance against the baseline. That audit trail is invaluable for project retrospectives and client billing disputes.

Limitations and common mistakes

Gantt Chart Benefits illustrated by a schedule ribbon where one shifted task visibly moves dependent bars and a milestone

  • Gantt charts age quickly. A chart that isn't updated at least weekly becomes misleading. Teams that treat it as a static document, created once and then abandoned, get none of the benefits and all of the false confidence.
  • False precision with long time horizons. A 12-month Gantt chart with tasks scheduled to the day is almost always wrong by week six. Detailed scheduling works for the near term (four to eight weeks out); use milestones and phases beyond that.
  • They don't show the "why" behind decisions. A Gantt chart records what and when, but not why a task exists, what "done" looks like, or the assumptions baked into the estimate. Pair it with a scope document and standard operating procedures.
  • Overcomplication kills adoption. Charts with 200 tasks and three nesting levels are impossible to read on a laptop screen. If people stop looking at it, it stops working. Keep the chart at a summary level and link to detailed task lists elsewhere.
  • Ignoring the critical path. Managers often focus on the longest bar rather than the path with zero float. Missing a three-day task with no float kills the deadline just as surely as missing a three-week task.

How to build a Gantt chart in 6 steps

Step 1: List your tasks

How to Build a Gantt Chart illustrated by a wide six-stage construction path building a complete timeline from blank task cards

Start with a work breakdown structure. Write down every deliverable, then decompose each one into the tasks required to produce it. Keep tasks at a level where one person owns them and they can be completed in one to ten working days. Tasks that span months are really phases; tasks that take hours belong in a checklist, not a chart.

Step 2: Estimate task durations

For each task, estimate the working-day duration. Use historical data from similar past projects where possible. If you're estimating blind, get input from the person doing the work rather than the person managing it. Build contingency into the schedule at the phase level, not by padding every individual task.

Step 3: Identify dependencies

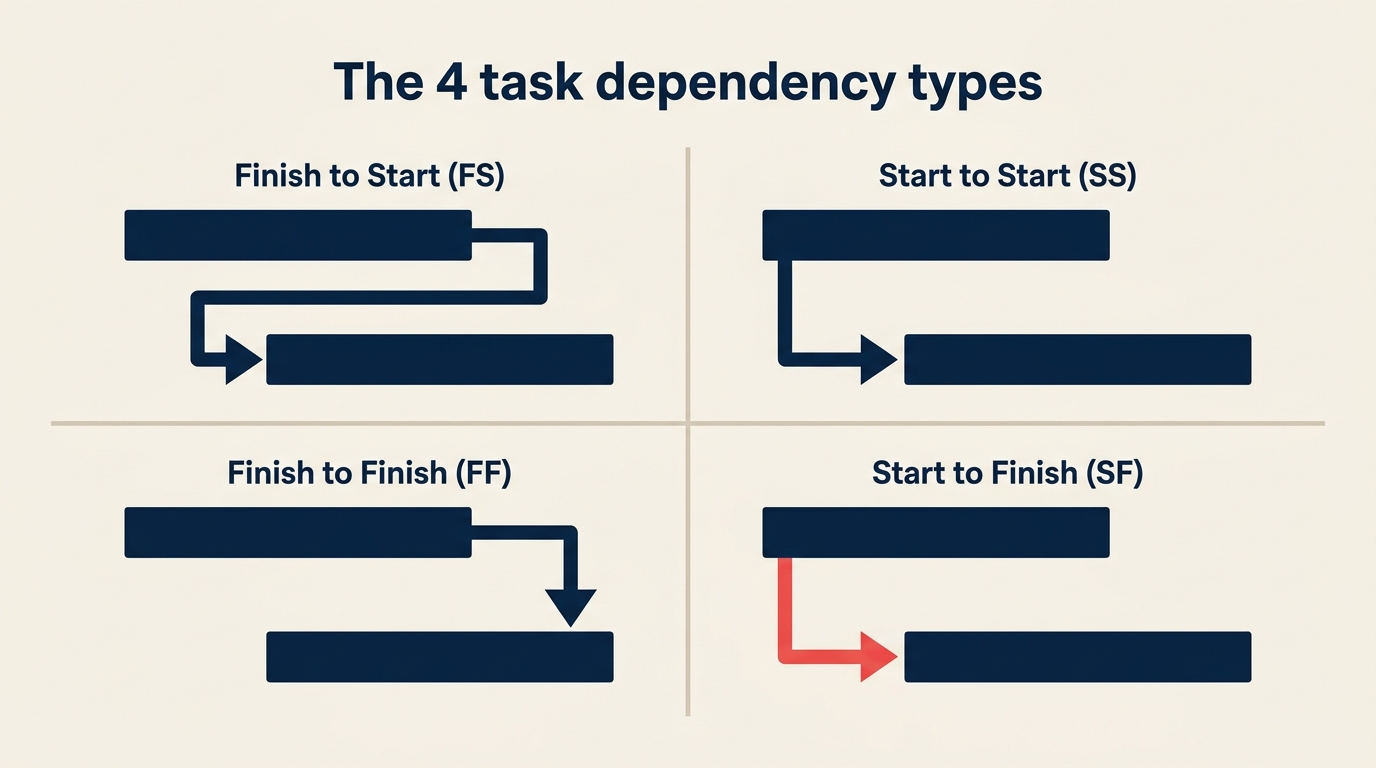

Map out the finish-to-start, start-to-start, finish-to-finish, and start-to-finish relationships between tasks.

  • Finish-to-start (FS): Task B can't start until Task A finishes. The most common type.
  • Start-to-start (SS): Task B can start once Task A has started (often used for parallel ramp-ups).
  • Finish-to-finish (FF): Task B can't finish until Task A finishes (quality review finishing with testing, for example).
  • Start-to-finish (SF): Task B can't finish until Task A starts. Rare, mostly used in shift handovers.

Document your dependencies before touching the chart tool. It's much faster to wire them in when you already know the relationships than to figure them out inside the software.

Step 4: Add resources and owners

Assign a person (or role) to each task. Check the resulting schedule for resource conflicts: if the same person appears on three simultaneous bars, something needs to shift. This step is where many project plans first touch reality.

Step 5: Plot the timeline and milestones

Place each task bar on the time axis using its start date, duration, and dependencies. Add milestone markers at key delivery gates: design approval, stakeholder review, go-live, regulatory filing, whatever matters most to the project. Milestones have zero duration; they're a point in time, not a range.

At this stage, check the critical path. The sequence of tasks with zero float determines your earliest possible completion date. Any delay on that path delays the whole project, no exceptions.

Step 6: Review, baseline, and update

Walk the chart with the full team before calling it final. People often spot missing tasks, unrealistic durations, or dependency errors that the PM missed. Once everyone agrees, lock the baseline. That frozen snapshot becomes your reference point for every future status conversation.

Then update the chart on a regular cadence, at least weekly on a fast-moving project, biweekly on a slower one. Marking actual progress against planned progress is what turns a Gantt chart from a planning artifact into a live management tool.

Gantt chart examples by use case

Website redesign

Gantt Chart Examples illustrated by three distinct miniature timeline artifacts for a website, campaign, and building fit-out

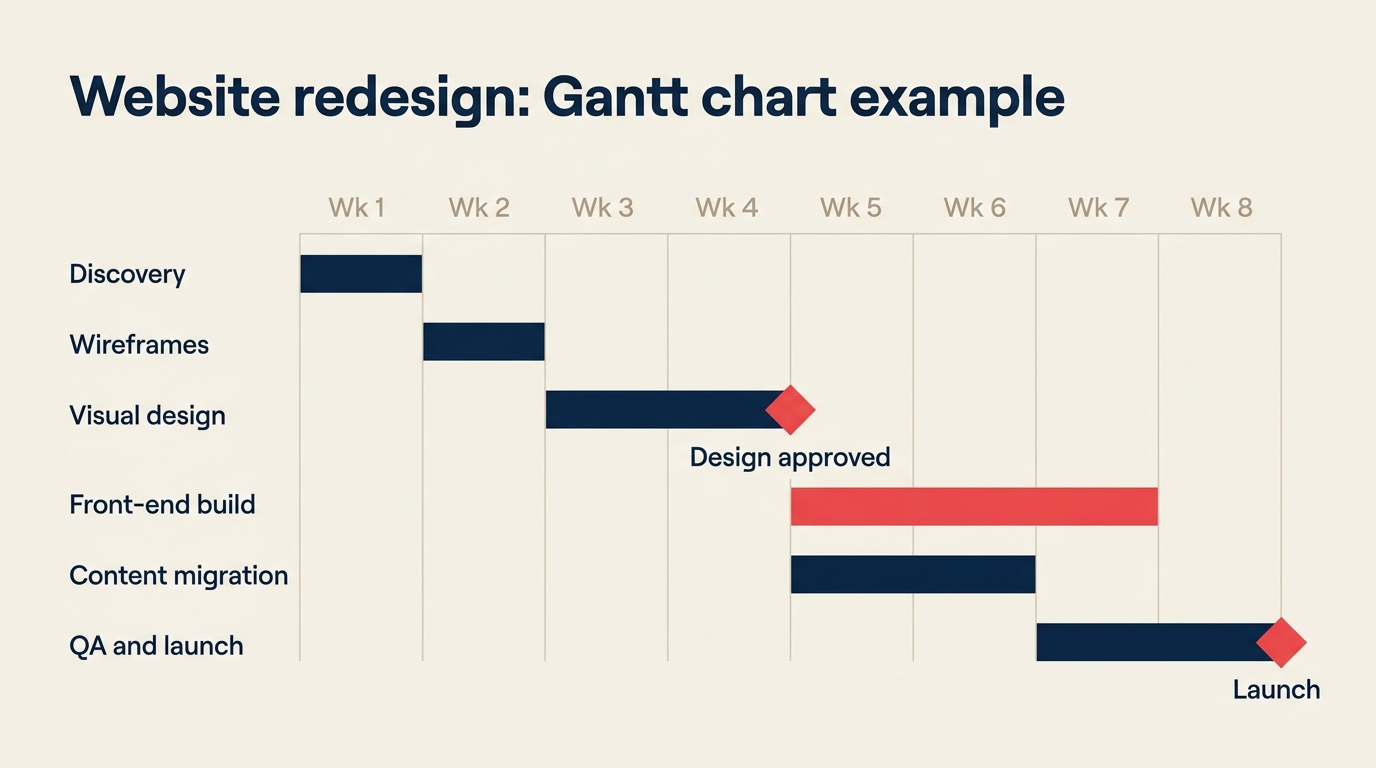

Task Owner Start End Dependency % Complete
Discovery and stakeholder interviews UX Lead Wk 1 Wk 1 None 100%
Wireframes and information architecture UX Lead Wk 2 Wk 3 Discovery 100%
Visual design and brand application Designer Wk 3 Wk 4 Wireframes (FS) 60%
Front-end development Dev Lead Wk 4 Wk 6 Visual design (FS) 0%
Content migration Content Mgr Wk 5 Wk 7 Front-end (SS) 0%
QA testing and bug fixes QA Engineer Wk 7 Wk 7 Front-end, Content 0%
Launch PM Wk 8 Wk 8 QA sign-off 0%

Marketing campaign launch

Task Owner Start End Dependency % Complete
Campaign brief and audience research Marketing Dir Wk 1 Wk 1 None 100%
Creative concepting Creative Lead Wk 2 Wk 2 Brief (FS) 80%
Copy and asset production Copywriter + Designer Wk 3 Wk 4 Concept approval 0%
Paid media setup (ads, targeting) Media Buyer Wk 4 Wk 5 Assets ready (FS) 0%
Landing page build Developer Wk 4 Wk 5 Copy + assets (SS) 0%
Internal review and legal sign-off Legal Wk 5 Wk 5 All assets (FF) 0%
Campaign go-live Marketing Dir Wk 6 Wk 6 Legal sign-off 0%

Construction fit-out

Task Owner Start End Dependency % Complete
Site survey and permits Project Mgr Wk 1 Wk 2 None 100%
Demolition and strip-out Site Foreman Wk 3 Wk 4 Permits (FS) 40%
Electrical and plumbing rough-in MEP Contractor Wk 4 Wk 6 Demolition (FS) 0%
Drywall and ceiling General Contractor Wk 6 Wk 7 Rough-in (FS) 0%
Finishes (paint, flooring, fixtures) GC Sub Wk 7 Wk 9 Drywall (FS) 0%
Inspections and snagging Project Mgr Wk 9 Wk 10 Finishes (FF) 0%
Handover Project Mgr Wk 10 Wk 10 Inspection passed 0%

Best practices for Gantt charts

  • Keep the top-level chart at the summary level. Show phases and major deliverables at the main view; let people drill into detail tasks only when they need them. A chart that fits on one screen gets used; one that requires horizontal scrolling gets ignored.
  • Update it before the weekly status meeting, not during. Nothing kills the energy of a project review faster than spending the first 20 minutes refreshing a chart in real time. Update first, discuss second.
  • Never hide bad news in the chart. If a task slips, move it. The chart should reflect reality, not aspirations. A schedule that looks green while the project burns red is worse than no chart at all.
  • Build in lag time for external dependencies. When your schedule depends on a vendor, a client approval, or a government permit, add buffer. Those inputs almost never arrive on the exact day requested.
  • Pair the chart with a RACI matrix. A Gantt chart shows when tasks happen; a RACI matrix shows who is responsible, accountable, consulted, and informed for each one. Together, they eliminate most "I didn't know that was mine" moments.
  • Use the waterfall methodology framing for fixed-scope projects. Gantt charts are a natural companion to waterfall delivery. If you're in an agile shop, use rolling-wave planning: detail the next two sprints fully, sketch the following three months as milestones only.
  • Color code strategically, not decoratively. Use one color for on-track tasks, one for at-risk tasks, and one for the critical path. More than three colors creates visual noise and people stop reading the legend.
  • Review the chart at each project phase gate. Don't wait for a monthly report to catch drift. A quick comparison of planned vs. actual at each milestone keeps surprises small and manageable. Integrating this into your business process management rhythm makes it sustainable.

Gantt charts have survived more than a century of project management evolution because they solve a real problem: teams need to see where they are relative to where they planned to be. A well-maintained Gantt chart won't save a project with an impossible deadline or an unclear scope. But for teams that have a clear goal and a realistic plan, it's one of the most effective tools for keeping everyone aligned from kickoff to close.
